Most companies don't wonder how to do data migration for its own sake. They want to enable something missing, fix a bottleneck, or cut costs: an AI capability a legacy stack can't support, a cloud platform that scales, a compliance posture that holds up to a regulator. Data migration is the bridge to all of those, and it's often the first step in a broader legacy app modernization or digital transformation effort. In fact, Gartner has projected that by 2026, the majority of enterprise data architectures will need reworking to support digital transformation.
The catch is that moving data is one of the most underestimated projects in enterprise IT. Industry research from Gartner indicates that roughly 83% of data migration projects either fail outright or overrun their budgets and timelines. Bloor Research has put average cost overruns near 30% and schedule slippage around 41%. McKinsey has noted that migration inefficiencies tend to cost enterprises meaningfully more than planned. Those numbers have barely moved in a decade, which tells you the problem isn't the technology. It's the approach.
This guide lays out the business case for migrating, the three core approaches to moving and cutting over, the concerns that derail executive sponsors, and how to choose a partner who reduces your risk rather than adding to it.
Typical reasons companies need data migration services
Before choosing how to migrate, it helps to be honest about why you’re migrating your data in the first place. The strongest migration programs start with a business outcome, not a platform decision.
AI readiness: This is the dominant driver heading into 2026. The uncomfortable truth is that low-quality, poorly organised data - not weak algorithms - is the leading reason enterprise AI efforts stall. Legacy environments lock data into proprietary formats and siloed systems that AI tooling simply can't reach. You can't build reliable models on data your platforms can't serve cleanly. Migration is often the unglamorous first step of any credible AI roadmap.
Legacy modernisation: Software built in the 1990s and 2000s carries rising maintenance costs as original vendors withdraw support, and it quietly drains agility. Gartner's CIO research has shown application modernization sitting among the top areas of increased IT spending, while investment in legacy infrastructure declines. Migrating data off aging systems is how that modernisation actually gets realised. For better decision timing, see Dreamix's guide on
Cloud economics and scale: Moving from on-premises infrastructure to cloud platforms remains a core motivation, driven by cost flexibility, elastic scale, and resilience. McKinsey reports that businesses experience 35% cost reduction after cloud migrations.
If a cloud move is on your roadmap, our cloud migration checklist for enterprise CTOs breaks the planning down phase by phase.
Consolidation and analytics: Data scattered across systems can't be analyzed as a whole. Many migrations exist to bring fragmented data into a unified, accessible environment so leaders can actually trust their dashboards.
A useful discipline: write down the business case in one sentence before anyone discusses tooling. If you can't, the project isn't ready.

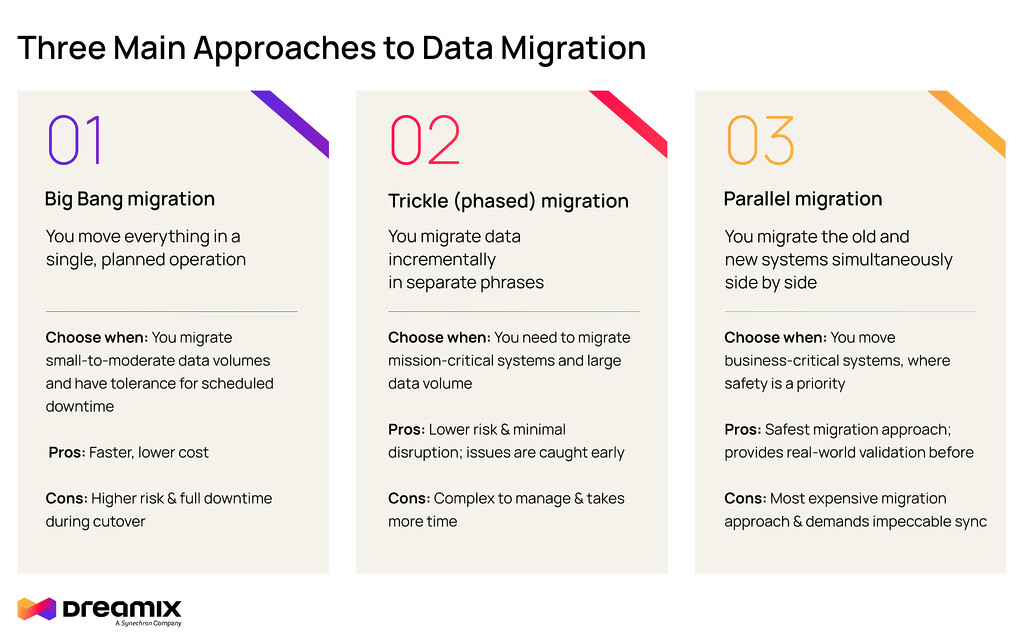

The 3 approaches to data migration
Most data migration questions reduce to a single concern: how to transfer the data and transition users onto the new system while keeping transactions consistent and the business running throughout.
The right one depends almost entirely on how much downtime you can afford and how much risk you're willing to carry.
1. Big Bang migration
In the Big Bang migration approach, you move everything in a single, planned operation, usually during a downtime window such as a weekend or holiday. The appeal is speed and lower cost: there's no need to keep two systems running at once, and the project has a clean finish line. The risk is concentration. Every system is unavailable during the cutover, and if something breaks, it breaks all at once.
Big bang works best for smaller data volumes, simpler architectures, and businesses that can genuinely tolerate a defined outage. It rarely fits mission-critical systems that have to stay available around the clock.
- Best for: Small-to-moderate data volumes, simpler systems, businesses with a real tolerance for scheduled downtime
- Upside: Faster, lower cost, clean break between old and new
- Downside: High risk concentrated in one event; full downtime during cutover; limited ability to test in a live environment
2. Trickle (phased) migration
In the phased or trickle migration approach, companies migrate data incrementally, in defined phases, while the old system keeps running. It applies an Agile mindset to data transfer: the project is broken into sub-migrations, each with its own scope, timeline, and quality checks. Problems surface early, on a small scale, instead of all at once. The trade-off is duration and complexity, and the need to keep users working across a transition that lasts longer.
Trickle is the safer choice for large datasets and mission-critical environments that can't absorb a hard stop.
- Best for: Large data volumes, mission-critical systems, organizations that need to keep operating throughout
- Upside: Far lower risk; minimal disruption; problems caught and fixed incrementally
- Downside: Takes longer; more complex to manage; you're maintaining a transition state for an extended period
3. Parallel migration
In the third data migration approach, businesses simultaneously run the old and new systems fully side by side for a certain period, with data kept synchronized across both, and switch over only once the new system is proven.
The parallel migration is the most conservative approach: users effectively have a working fallback the entire time, which makes it attractive for systems where failure is simply not acceptable. The cost is the highest of the three, because you're operating two environments at once and building synchronization logic to keep them consistent until the final switchover.
For a concrete look at how this works in practice, see our walkthrough of zero-downtime data migration using PostgreSQL logical replication.
- Best for: The most sensitive, business-critical systems where a safety net during cutover is worth the expense
- Upside: Strongest risk protection; real-world validation of the new system before commitment; immediate fallback
- Downside: Most expensive approach; demands robust, well-tested synchronization needed

Choosing the right data migration approach for you
In practice, large legacy modernisation programs rarely pick just one data migration strategy. A common pattern is to use Big Bang for simple batch workloads while putting the sensitive, real-time systems on a trickle or parallel approach.
When the workloads in question are applications rather than raw data, our guide on migrating applications to the cloud covers the sequencing considerations in more depth. The unifying principle is to sequence by risk: retire low-value systems first, prove the process on something forgiving, then move the core once the team has earned confidence. The single most important input to this decision is your cost of downtime, which we'll come back to below.
Migration versus modernization: a distinction worth making
The three approaches above are data migration strategies: they govern the cutover.
Separately, if you're moving off a legacy platform, you'll face a modernization choice about how much to transform each application and its data architecture en route. The standard framework here is the "7 Rs," popularized by AWS and used widely to classify workloads:
- Retire: shut down applications that no longer serve a purpose. The cheapest move of all, and it shrinks the scope of everything that follows.
- Retain: leave a workload where it is for now, usually because it isn't worth moving yet or compliance dictates it stays put.
- Rehost ("lift and shift"): move with minimal change. Fastest, but you carry existing inefficiencies with you.
- Relocate: move workloads to the cloud without changing them, typically VM-level moves that preserve existing tooling.
- Replatform: make targeted optimizations, such as moving to a managed database, without a full rewrite. Often the pragmatic middle ground.
- Repurchase ("drop and shop"): replace a legacy system with a different product, frequently a cloud-native SaaS alternative.
- Refactor / rearchitect: redesign the application to fit the cloud properly. The most effort, but where the lasting gains for AI readiness and scale tend to live.
Most enterprise programs apply several Rs across the portfolio: retire the dead weight, rehost the commodity workloads, and reserve refactoring for the strategic systems where it pays off.
For a deeper treatment of these trade-offs in a cloud context, see our guide on migrating legacy applications to the cloud.
The practical takeaway: Decide the migration strategy (big bang, trickle, or parallel) based on downtime and risk tolerance, and decide the modernization tactic based on how much business value the destination architecture needs to unlock. A phased migration paired with incremental rearchitecture, for instance, is a far lower-risk path than a single big-bang rewrite, which has a well-documented record of failure.
Latest article: Databricks Data Intelligence Platform: 7 Business Advantages
Concerns business leaders should watch for
The most expensive migration mistakes are rarely a single dramatic failure. They're predictable patterns that compound quietly.
Treating migration as purely technical: The classic error. Migration touches business processes, compliance, and how teams will work in the new environment. Framed as an IT task, it loses the executive sponsorship and cross-functional input it needs to succeed.
Underestimating downtime cost: Your choice of migration strategy hinges on a real number for what an hour of downtime costs you. ITIC's recent surveys found that the large majority of mid-size and large enterprises put a single hour of downtime above $300,000, with a significant share reporting $1 million or more. Gartner has noted that for the largest companies, and especially in finance and healthcare, the figure can run into the millions per hour. That number, not engineering preference, should drive whether you choose big bang, trickle, or parallel.
Skipping data quality and discovery: Assuming you know your data is how migrations balloon in time and cost. A complete inventory and quality assessment before you move anything is the single highest-return activity in the project.
No rollback plan: Hope is not a cutover strategy. A credible migration has tested rollback procedures and a clear definition of what "success" looks like before go-live, validated against a mirror of production.
Compliance as an afterthought: For regulated sectors, requirements such as the EU's Digital Operational Resilience Act, in force since January 2025, or sector frameworks like HIPAA, have to be designed in from the start. Deloitte's guidance is consistent here: bake security and compliance requirements into the process up front rather than bolting them on at the end, when fixing them is far more costly.
How to choose the right data migration partner
Specialized data migration services companies bring methodologies refined across hundreds of projects, tooling they've already built, and lessons learned on someone else's budget. But partner selection itself is a major risk decision. As one recent enterprise framework put it, when migrations fail, the partner decision was often the first problem and the platform only the second. Here's what separates a genuine partner from a vendor selling hours.
Relevant industry track record: Ask for case studies from companies with similar starting points, data volumes, and regulatory constraints, then actually check the references. A partner who has migrated in your sector understands its specific compliance and data-classification complexity; a general integrator routinely underestimates it.
A documented methodology they'll walk you through: A strong partner explains exactly how they run pre-migration assessment, sequence workloads, handle rollback, and manage cutover, in detail, not as a slide with three phases on it. Ask them to talk through a migration most like yours. Specificity in the answer is the signal.
Seek business value, not body-leasing: The right tech partner can challenge your assumptions to understand the actual goal, rather than quietly executing whatever spec they're handed. The difference shows up as fewer surprises and a solution that fits the business, not just the ticket. This is exactly the distinction Dreamix draws: product development and delivery process, not staff augmentation by the hour.
Our overview of digital transformation consulting essentials explains what that partnership model looks like in practice.
Security and compliance depth: For regulated workloads, confirm documented experience with your specific frameworks, encryption in transit and at rest, and the access controls your auditors will ask about.
Commercial alignment: Understand the pricing model. Fixed-fee engagements can incentivize scope compression; outcome-based models require precise, agreed metrics up front. Match the structure to how much certainty you actually have about scope.

The takeaway
Data migration has become unavoidable, because the things executives want most, AI capability, modern platforms, cloud economics, regulatory resilience, all sit on the other side of it. The failure statistics are sobering, but they describe projects run as technical exercises with thin planning. The ones that succeed start from a clear business case, choose a migration approach (big bang, trickle, or parallel) matched to their real downtime tolerance and risk appetite, invest heavily in discovery and data quality before moving anything, and bring in a partner who reduces risk rather than billing against it.
Get those four things right, and migration stops being a project you survive. It becomes the foundation for whatever you're trying to build next.
FAQs regarding data migration:
We’d love to hear about your data migration project and help you meet your business goals as soon as possible.
